Trench Quantities in Bank, Loose, and Compacted Yards

The Problem

Trench quantities are prism arithmetic — width times depth times length, minus the pipe. Nobody gets the prisms wrong. What goes wrong is that the same dirt is three different volumes depending on where it's sitting: in the ground, in the truck, or compacted back in the trench. Order bedding rock off the neat-line number and you run short; schedule haul-off trucks off the bank volume and you're a truck or two light every day; and the supplier's tickets are in tons while the inspector thinks in cubic yards.

The Approach

The neat-line volumes are the easy part, all in bank measure:

Excavation = W × D × L    Pipe zone = W × (OD + h_zone) × L − V_pipe

where the pipe displaces π/4 × (OD/12)² × L. The tool then converts each stream to the measure that matters for it [2]:

It finishes the chain with import tonnage at the material's density and a truckload count, because that's the number the phone call to the yard actually needs.

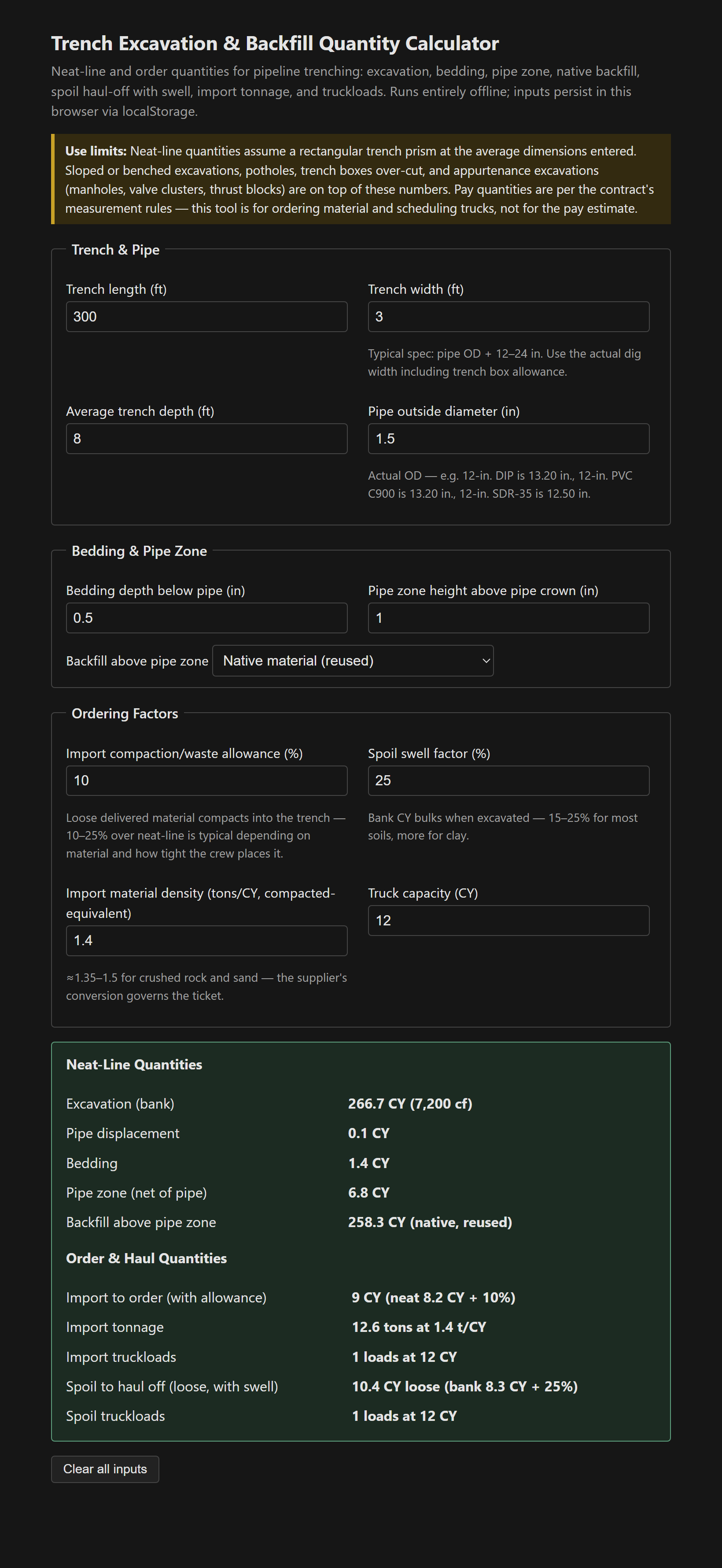

Calculator output showing excavation, bedding, pipe zone, spoil with swell, import tonnage, and truckloads
Figure 1: One trench section carried through from neat-line prisms to tons and truckloads.
Field notes that ride along
  • Depth varies along a run on grade — use the average of station depths, or split into reaches and run the tool per reach.
  • If a trench box sets the dig width, use the box width plus 6–12 in. of over-cut, not the spec minimum trench width.
  • Unsuitable subgrade means over-excavation and extra bedding — a re-run with the deeper numbers is the change-order quantity backup, dated the day it happened.
  • Keeping bank/loose/compacted straight on the daily report saves the argument at the pay application.

Single file, vanilla JS, inputs persisted in localStorage. Measurement-and-payment rules in the contract spec govern what's actually payable — this computes what's actually in the ground [1].

The tool: Trench Excavation & Backfill Quantity Calculator.

References

  1. [1] Contract specifications — trench detail, bedding/zone materials, and measurement/payment rules (governing).
  2. [2] Caterpillar Performance Handbook — swell/shrink factors by material type.
  3. [3] Pipe manufacturer dimension tables — actual ODs by material and pressure class.
